Category: Project Updates

  • ERO Board approves Authorization for  Construction of 99 MW Kosuriq Solar Park

    ERO Board approves Authorization for Construction of 99 MW Kosuriq Solar Park

    26.10.2026, Prishtina

    On October 26, 2026, the Energy Regulatory Office (ERO) Board officially approved the Authorization for the Construction of the 99 MW Kosuriq Solar Park, marking a defining milestone in the project’s development roadmap.

    With this key regulatory decision secured, the project transitions into a fully Ready-to-Build (RTB) phase. All approvals are now complete, meaning no further permits are required before ground-breaking for solar park. At the same time Solariss team is working on finalizing permitting for construction of OHL.

    Construction mobilization is set to begin next, moving Kosuriq Solar Park from planning into active execution on the ground.

    ERO Press Release: https://www.ero-ks.org/zrre/sq/komunikate-71

  • Solar Park Kosuriq ready for ERO Board Authorization

    18.07.2026, Prishtina

    Following the submission of the Application for Authorization for the Construction of New Generation Capacities for the 99 MWAC Solar Park in Kosuriq on 19 June 2026, the Energy Regulatory Office (ERO) completed its review of the application and supporting documentation. Subsequent to the settlement of the required administrative authorization fee and the completion of the mandatory public notice period published in two local daily newspapers on 10 July 2026 (spanning eight calendar days) with no public objections, inquiries, or complaints received, the application is deemed administratively complete and submitted for ERO Board review and final authorization decision

    ERO announcement:

    https://www.ero-ks.org/zrre/sq/njoftimi-publik-aplikacioni-autorizim-solariss-llc

    Announcement:

    https://solariss.llc/uncategorized/njoftim-publik-autorizim/

  • Expropriation Elaborate for 110 kV OHL submitted to MESP

    22.06.2026, Prishtina

    Following KOSTT JSC’s technical design approval for the 110 kV overhead line (OHL), Solariss LLC’s contractor, Elektrostublla Sh.p.k., in close collaboration with licensed surveyors and property appraisers, finalized the Expropriation and Servitude Elaborate for the OHL corridor.

    With Solariss LLC securing the required expropriation Bank Guarantee, Solariss LLC and KOSTT JSC jointly submitted the elaborate to the Ministry of Environment and Spatial Planning (MESP) for official review and processing, in full compliance with Law No. 03/L-139 on Expropriation of Immovable Property.

  • Application for Authorization submitted to ERO

    19.06.2026, Prishtina

    Solariss LLC submited to the Energy Regulatory Office of Kosovo (ERO) the application for authorization for construction of new generation assets, a 99 MWAC Solar Park in Kosuriq.

    Legal basis: https://www.ero-ks.org/zrre/sites/default/files/Publikimet/Vendimet/Vendimet%202022/Authorization%20Procedure%20for%20Construction%20of%20Energy%20Projects_ANG_%20per%20Kon.pdf

  • KOSTT approves Substation and OHL Design

    KOSTT JSC has officially approved the detailed designs for the 33/110 kV Kosuriq Substation and the 100 kV overhead transmission line.

    This key project milestone clears the way for finalizing the Expropriation and Servitude Elaborate for the overhead line corridor.

  • Construction Permit issued

    24.11.2025, Prishtina

    Solariss LLC has been granted by Ministry of Environment, Spatial Planning and Infrastructure (MESPI) with Construction Permit for construction of Kosuriq Solar Park.

  • Design of 33/110 kV Substation and 110 kV Overhead Line

    Solariss LLC awarded contract to Elektrostublla SH.P.K. for design of the 33/110 kV, 2×63 MVA Substation at Kosuriq, define the route and design 110 kV OHL from Kosuriq to SS Peja 3, and to support with documentation for OHL Construction Permit.

  • Grid Connection Agreement signed

    Grid Connection Agreement signed

    13.12.2024, Prishtina

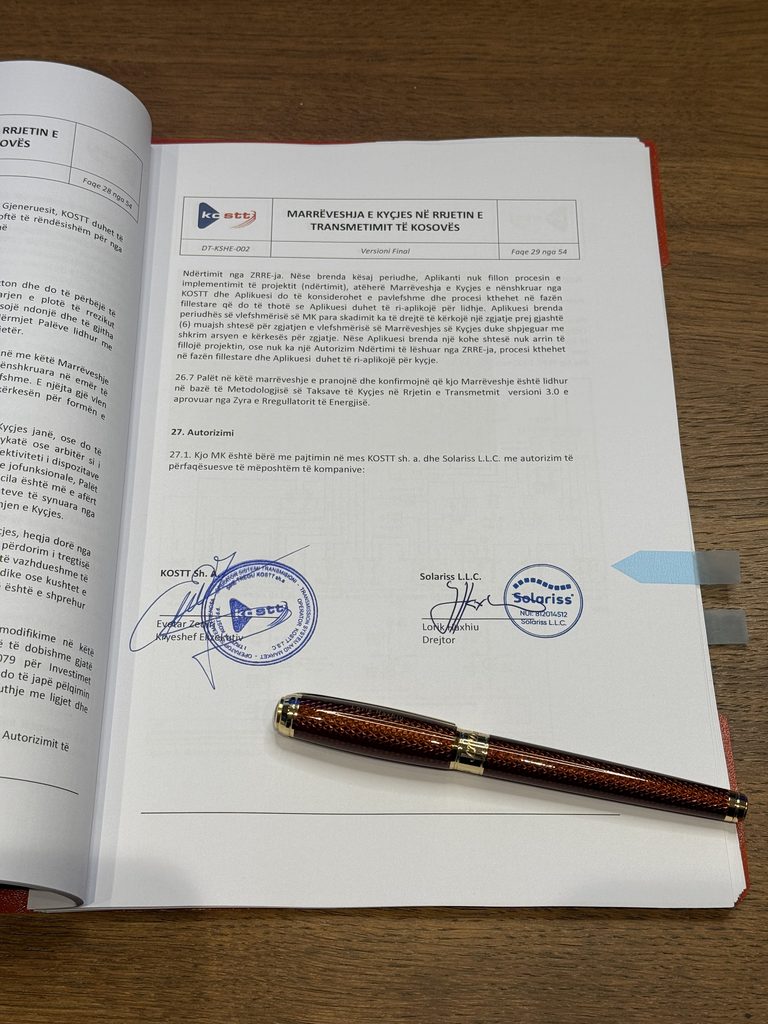

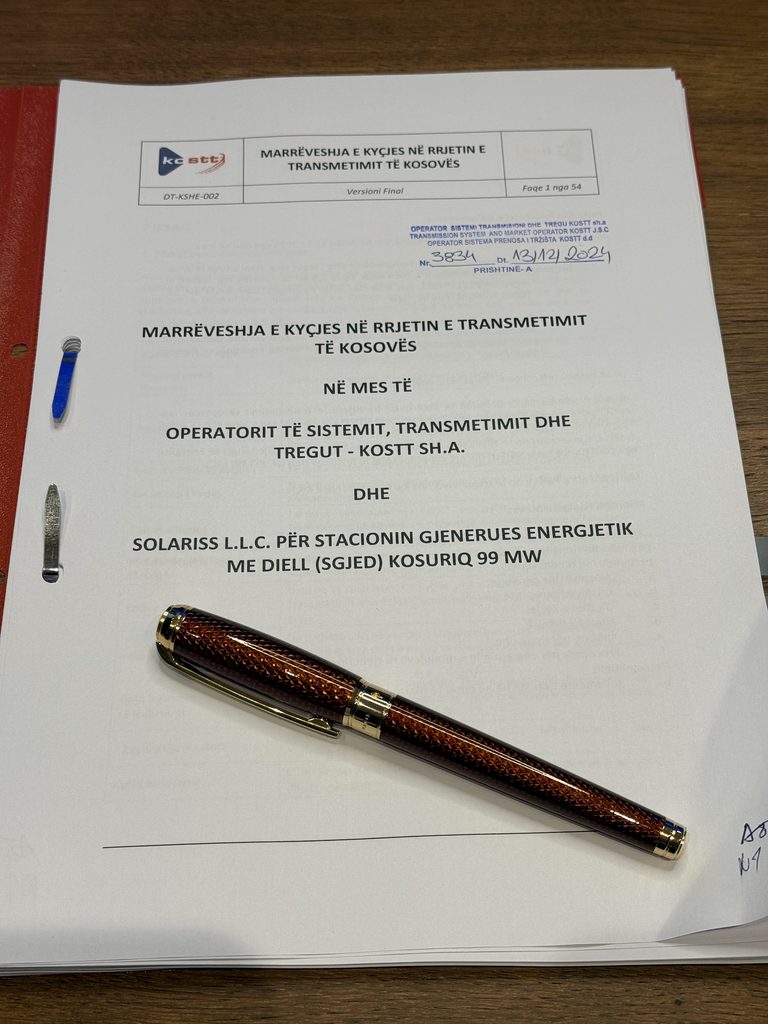

    Solariss LLC and KOSTT JSC signed a Grid Connection Agreement for the 99 MWAC solar park in Kosuriq.

  • Construction Conditions issued

    27.08.2024, Prishtina

    Ministry of Environment, Spatial Planning and Infrastructure (MESPI) issued the Construction Conditions for Kosuriq Solar Park.

  • USAID’s Energy Sustainability Activity (ESA) and Solariss LLC sign a Memmorandum of Understanding

    USAID’s Energy Sustainability Activity (ESA) and Solariss LLC sign a Memmorandum of Understanding

    Tetra Tech’s USAID-funded Energy Sustainability Activity (ESA) has signed a Memorandum of Understanding with Solariss L.L.C. to accelerate renewable energy deployment in Kosovo.

    Through this cooperation, ESA will provide technical, regulatory, and stakeholder engagement expertise to support Solariss in developing a 100-megawatt solar project in the village of Kosuriq, Peja municipality.

    Key areas of collaboration include:

    • Regulatory & Institutional Guidance: Navigating application processes with key entities such as the Ministry of Environment, Spatial Planning and Infrastructure, Energy Regulatory Office (ERO), and KOSTT.
    • Community Engagement: Advising on public consultations and local community initiatives.
    • Private Sector Enablement: Removing market barriers to improve Kosovo’s long-term energy security, regional integration, and economic growth.

    Partnering with local developers to turn renewable energy ambitions into reality.
